cis-case-study-logo

From spreadsheet commission chaos to one auditable source of truth

A telecom and IT services brokerage was running catalog, orders, and multi party commissions across a generic CRM and a sprawl of Excel. We rebuilt it as a single operational platform with the commission engine at its core.

cis-case-study-logo
Industry
Telecom
Type
Operations Platform
Timeline
5 to 6 Months
Stack
Next.js, NestJS, PostgreSQL
Tell us what you're building
  • 3 disconnected systems
  • Manual month end
  • Cash leakage on commissions
  • No audit trail

Before

Telecom operations platform badge
  • One platform
  • Auto tracked commissions
  • Live order margin
  • Who changed what, on every record

After

Ui visuals
The problem

The tooling never modeled their actual business

A generic CRM with no concept of reseller margins or multi party commissions, plus Excel for the commission math, the price book, and order financials, all reconciled by hand. As reps and deals grew, month end became both a bottleneck and a liability.

Three pain points

[01]

Commission accuracy

Multi role payouts and clawbacks by hand bred disputes and overpayments

[02]

No source of truth

Unit cost versus bill price versus margin lived nowhere reliable

[03]

No audit trail

Nobody could say who changed a payout or an order

Did you know?

56% of companies encounter commission errors on a regular basis, and over half of enterprise companies admit to commission disputes every single quarter.

According to Gartner, over 70% of companies still use spreadsheets to manage sales commissions. They're structurally wrong for it. Excel is single user and has no native way to connect to CRM, ERP, or payroll, which makes the process slow, error prone, and non real time. At scale, some organizations take months to calculate commissions.

The design

Build the commission engine first. Everything else serves it.

We modeled commissions as first class entities with their own lifecycle, decoupled from orders. That one decision let a single sale spawn multiple commission records for multiple recipients, each tracked, paid, or clawed back independently, without ever corrupting the underlying order.

THE DECISION THAT SHAPED THE BUILD

Commissions as first class entities, decoupled from orders, each carrying its own deal lifecycle. That single call absorbed every complication that surfaced later instead of breaking under it.

Development

Inside the build, the requirement that surfaced sale by sale

“Rep earns a percentage” turned multi dimensional. Two CSEs sharing a deal, a Sales Manager earning an override, and the sale type (initial, upgrade, renewal) changing the math. The honest story is that it wasn't fully knowable upfront. The rules driven engine is what absorbed the churn.

  1. [01]

    Payment pending becomes Paid

  2. [02]

    Awaiting activation

  3. [03]

    Chargeback pending becomes Completed

  4. [04]

    Commission denied

The moment the client was nervous

The fear was simple. “The new system pays people the wrong amount and we have a revolt.” We ran the engine in parallel against a real historical month and showed it reproduced, and in places corrected, the spreadsheet's payouts line by line, with the audit trail behind every number.

The requirement that surfaced mid build

SSN and payment data turned this into the SOC 2 conversation. Field level PII encryption, strict role based access, and audit logging, which is the Activity Log on every order, commission, and employee record.

What we said no to

Deferred deeper accounting and ERP integrations and fancier reporting. Get the money, math and data protection right before adding surface area.

The hardest thing to validate (QA)

The commission math is combinatorial. We built a test matrix against hand calculated payouts, including every clawback path, and treated each workflow status transition as independently verifiable.

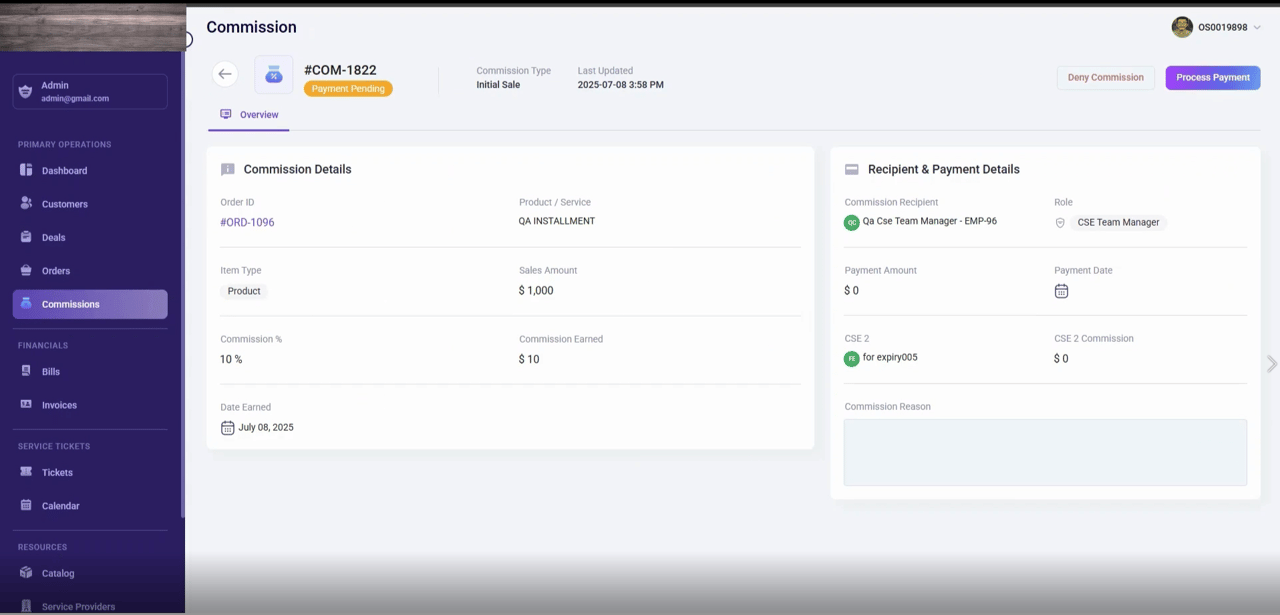

TELECOM COMMISSIONS
Delivery

What the client can now do

Run an order from creation through renewal in one system with live margin and savings. Auto generate and track every commission across the role hierarchy with chargeback handling instead of recalculating in Excel. Onboard a rep via invite flow with the right permissions. And answer “who changed this and when” on any record.

Timeline

5 to 6 months, phased. Core lifecycle and commission engine first, dashboard and refinements second. The timeline bought correctness, not just screens.

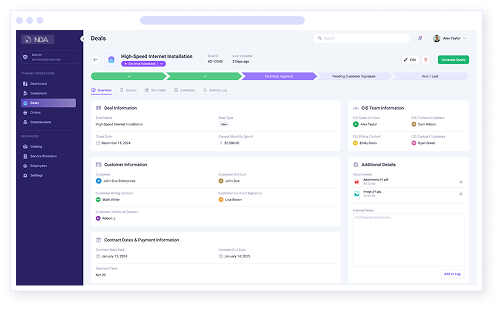

NDA case study delivery timeline shot

Early signal

Commission disputes at the first month end dropped versus the spreadsheet era, and reps began self serving their status from the dashboard instead of emailing finance. Post launch, requests clustered around reporting and forecasting. People asking for more analytics means they trust the data, which is the whole game.

NDA case study delivery shot

Read more case studies
